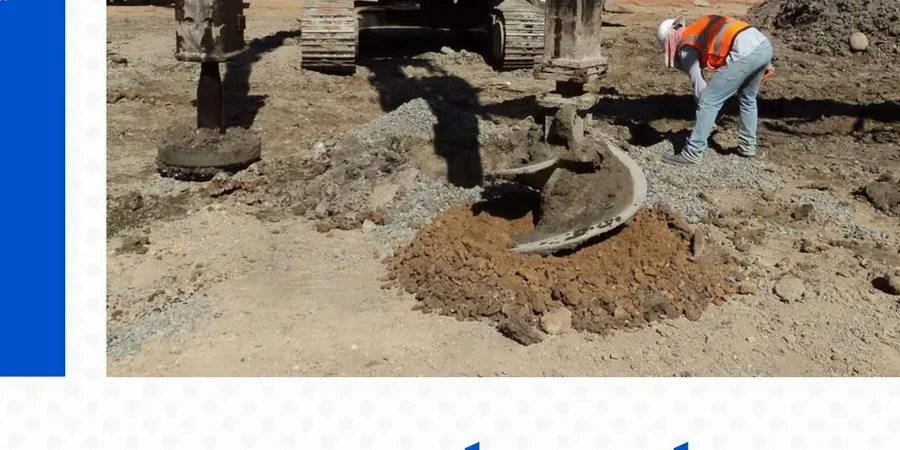

Commercial Stone Column Design in Wichita — Ground Improvement That Builds Faster

Rigorous testing. Clear reporting.

LEARN MORE

Wichita sits at 1,300 feet elevation on the Arkansas River floodplain, where loose alluvial sands and soft silts extend 30 feet deep across much of the city. For any warehouse slab or mid-rise structure east of the I-135 corridor, conventional shallow footings often hit refusal problems or trigger settlement beyond the 1-inch allowable limit. Stone column design changes that equation. We engineer vibro-replacement layouts that densify the in-situ soil and transfer loads to competent bearing strata, cutting total settlement by half or more compared to unimproved ground. The approach works particularly well in the 67202 and 67213 industrial zones, where the underlying Wellington Formation creates variable stiffness profiles that a standard CPT test can map before column spacing is finalized. Our team delivers IBC-compliant construction drawings that let your contractor order stone and start work without six weeks of redesign loops.

A well-designed stone column grid can reduce post-construction settlement by 50-70% in the loose alluvial soils that underlie Wichita's industrial corridors.

Our service areas

Our approach and scope

Wichita's freeze-thaw cycle runs about 90 days per year, and the expansive clay lenses within the alluvium swell noticeably during the spring wet season. That seasonal movement wreaks havoc on slabs supported by untreated ground, producing differential heave that cracks partition walls and binds overhead doors. Stone columns mitigate this by creating vertical drainage paths and replacing compressible material with compacted aggregate. In a typical 40-foot by 60-foot footprint, we might specify 18-inch diameter columns on a 6-foot triangular grid, extending to depths of 15 to 25 feet depending on the refusal criteria. The design accounts for the column's lateral bulging capacity, which is critical in the silty sands common near the Big Ditch diversion channel. For sites with organic silt lenses thicker than 3 feet, we often pair the stone column layout with a plate load test to verify modulus of subgrade reaction before the floor slab is poured. The result is a predictable modulus under the entire building pad, eliminating the soft spots that drive up post-construction repair costs.
Commercial Stone Column Design in Wichita — Ground Improvement That Builds Faster
Technical reference — Wichita

Local considerations

The costliest shortcut we see in Wichita is a contractor ordering stone columns from a rule-of-thumb spacing chart without a site-specific design. A grid that works in clean sands near Maize Road can fail completely in the silty deposits three miles east, where the fines content exceeds 15 percent and column drainage is slower. The column bulges into the soft silt instead of densifying it, and the floor slab settles 2 inches in the first two years. The owner is then stuck with a $150,000 slab replacement and a ground improvement contractor who has already moved on to the next job. A proper design backed by a grain size analysis and in-situ testing eliminates that risk. It tells you the column length, diameter, spacing, and the exact load transfer platform thickness needed for the soil profile at that specific address.

Need a geotechnical assessment?

Reply within 24h.

Email: [email protected]

Reference standards

IBC 2021 Chapter 18 (Soils and Foundations), ASCE 7-22, ASTM D1586 (Standard Penetration Test), ASTM D2487 (Soil Classification), FHWA NHI-16-027 (Ground Improvement)

Typical values

ParameterTypical value
Typical column diameter18-36 in
Grid patternTriangular or square
Typical depth range in Wichita alluvium15-30 ft
Design methodPriebe (1995) / unit cell
Target post-treatment SPT N-value15-25 blows/ft
Load transfer platform12-18 in compacted gravel
Settlement reduction factor2-4 typical

Frequently asked questions

How much does a stone column design for a Wichita commercial site cost?

Engineering design fees for a stone column ground improvement plan in Wichita typically range from US$1,300 for a straightforward single-building pad to US$5,910 for a multi-acre industrial site with variable soil conditions and complex column layouts. The final cost depends on the site footprint, number of borings or CPT soundings required, and the review scope needed for IBC compliance.

How long does the design process take?

A typical stone column design in Wichita takes 10 to 14 business days from receipt of final geotechnical data. The schedule depends on whether the site investigation is already complete or if we need to perform additional CPT soundings. We provide preliminary column layouts in 5 to 7 days for budgeting purposes while the final analysis is underway.

Do stone columns work in the expansive clay soils found in parts of Wichita?

Stone columns are not typically used to control expansive clay heave directly — that requires moisture conditioning or rigid inclusions. However, many Wichita sites have intermixed alluvial deposits where a stone column grid in the granular layers reduces total settlement while a structural floor or drilled pier system handles the clay heave component. We evaluate the profile from top to bottom and specify where stone columns add value and where a different treatment is needed.
